10th Street North Reconstruction Project


Zone: Downtown, NorthWhat zone am I?

Current

Start: May 2018

Estimated Completion: November 2018

10th Street North Reconstruction Project

10th Street North Reconstruction Project


Project Overview:

The City of Fargo along with the NDDOT is overseeing the complete reconstruction of 10th Street/US-81 from 4th Avenue to 12th Avenue North in downtown Fargo. This roadway is part of the U.S. Highway system. The project work will upgrade this stretch of roadway from a rural to urban roadway as well as improve safety.

With corridor improvements, proper sight lines for safety are reviewed during project design. In this eight-block roadway construction project, trees were identified for removal to help with safety and visibility for all users and to meet current federal requirements. Removal of trees will be ongoing throughout the construction activity.


Current Status:

In each direction traffic is head-to-head traffic with one-lane in each direction with left-hand turn lanes on University between 4th Avenue North to 12th Avenue North throughout the duration of the project. Local traffic only is maintained in the project limits.

Head-to-head detour route on University Drive will be removed between 4th Avenue – 12th Avenue by mid-November. With traffic control beginning to be removed in early November from both 10th Street North and University Drive.

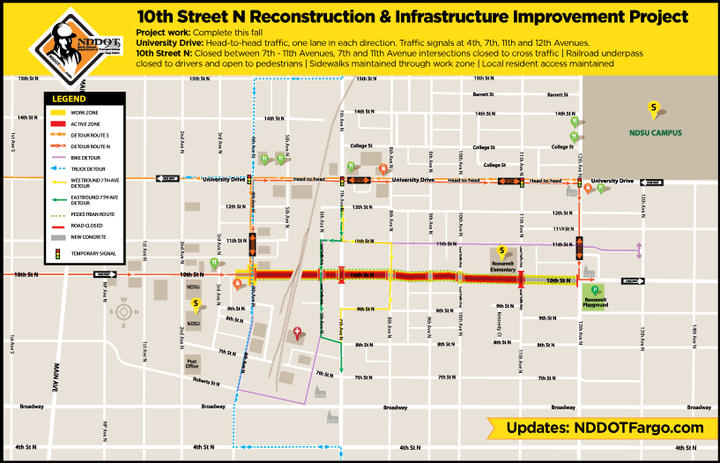

Current intersection access in the project:

CLOSED:

  • 6th Avenues North intersection
  • 600 and 1100 blocks of 10th Street North as well as railroad underpass between 4th – 6th Avenue North

OPEN:

  • 10th Street North east/west crossing at 7th, 8th, 9th, 10th, 11th and 12th Avenues North intersections
  • Pedestrian crossing to travel all directions will remain across the 7th Avenue North intersection
  • 700, 800, 900, and 1000 blocks of 10th Street North to local traffic only

DRIVER DETOUR ROUTE:

  • University Drive between 4th – 12th Avenue North, one-lane in each direction with left-hand turn lanes

UPDATED TRUCK DETOUR:

  • Westbound of University Drive on 7th Avenue North to south on 4th Street North to west on 4th Avenue North to north on 15th Street North
  • Eastbound of 10th Street North on 7th Avenue North to south on 15th Street North to east on 4th Avenue North to north on 4th Street North

BIKE DETOUR ROUTE:

  • 11th Street North, 4th and 6th Avenue North, and Roberts Street
  • The route will shift to 8th Avenue N when work begins at 6th Avenue N intersection

Ahead of Winter Suspension – end of 2018 work:

The work remaining on 10th Street North project is anticipated to take three weeks, weather permitting:

  • Tie-in to the existing storm system at 4th Avenue and 10th Street North may be complete
  • 10th Street North will have new concrete roadway surface from 6th Avenue to 12th Avenue North
  • Both sidewalks will be open including in the railroad underpass
  • Residential and business driveways will be new concrete and restored for use
  • Permanent roadway signage installed
  • Pedestrian crossing system, traffic signals and street lights will be installed when equipment arrives

Winter Suspension – Nov/Dec – May 2019:

Contractually, the contractor was only allowed to work on two of the four roadway reconstruction phases concurrently. With the cooler temperatures approaching, the NDDOT and City of Fargo did not allow the contractor to begin the third phase until the first two phases north of the underpass were 100 percent complete. The second phase was complete in late September.

10th Street North project will enter winter suspension in November/December.

The remaining project work is anticipated to take five weeks and will start after North Dakota State University spring semester is complete in May 2019.

Spring 2019 Traffic Control:

A head-to-head detour on University will be in use to accommodate final phases of project work in the underpass; however, it will be shortened significantly from 2018 project limits.

  • Planned detour will route northbound 10th Street North traffic to University Drive to be carried head-to-head with one driving lane in each direction between 4th Avenue North – 7th Avenue North intersection
  • All other one-way northbound traffic will remain on 10th Street North

Railroad Underpass Lift Station Project Work:

The 10th Street North underpass at the BNSF railroad crossing houses a storm water pump station behind the east wall of the underpass. The one access point for maintenance is from the roadway of 10th Street in the underpass. The original pump station was built in 1977 making the pumps and controls now 41 years old. The pump station was previously maintained by the railroad and on railroad land.

The new lift station is over 20 feet below the existing top of the underpass wall. To build the new structure to house the components for the storm sewer system, the new lift station construction schedule included:

First step: Build out of a temporary safety structure

  • Crews started by installing a sheet pile cofferdam to safely excavate the area bounded by the existing retaining walls, two building, large sign and railroad track grade
  • Once the temporary cofferdam was in place the hole for the new structure could safely be excavated and the structure built

Second step: Build out of the permanent structure

  • The new lift station structure was built behind the west wall of the underpass
  • The area around the structure was backfilled
  • Crews removed the temporary cofferdam

Third step: Make underground connections from system to lift station through the retaining wall

  • Crews worked to install the storm sewer connections from the underpass through the wall to the new lift station
  • This required removal of the existing retaining wall to make the pipe connection, and additionally the design called for the installation of a stronger wall from the pipe connection at the lift station and south
  • The stronger wall will support the new concrete roadway and sidewalk over the top of the lift station and new east wall to allow access to the lift station from the south
  • The new placement of the access into the lift station will allow City of Fargo service trucks to access for maintenance without affecting traffic on 10th Street North

Fourth step: Make additional underground connections to city utilities – weather permitting, phase will be complete in 2018

  • New storm sewer force main needs to be installed behind the wall from the pump station south to connect to the existing storm sewer in 10th Street North south of 4th Avenue intersection

Fifth step: Installation of control panels to make the lift station operational – phase will be complete in winter 2018

  • Crews will install underground control cabling to the lift station
  • Control cables for the signal lights for the new roadway and sidewalk will be installed
  • New lift station pumps, controls, and internal pump station valves and piping will be installed

Sixth step: Remaining underground connections under the driving surface will be made – phase will be complete in 2019

  • Roadway surface will be removed to finish the underpass utility connections to new pipes installed to the north. These connections will put the new lift station into service
  • The old lift station pumps, controls, and building will be removed to below existing ground, backfilled, and abandoned
  • 10th Street North roadway surface between 4th Avenue – 6th Avenue will be replaced with new concrete with underground complete

Seventh step: Permanent lighting, roadway markings and signage will be installed – phase will be complete in 2019

  • New lighting will be installed throughout the underpass
  • New permanent directional roadway signage and roadway striping will be installed to re-open the underpass

Purpose:

  • Remove some of the roadway curve out of 10th Street North between 8th and 10th Avenue
  • Improve pavement condition and ride quality of the 30 year-old plus roadway
  • Complete area infrastructure improvements and upgrade aging facilities of storm sewer, water main and sanitary sewer
  • Improve load-carrying capacity
  • Upgrade pedestrian facilities, traffic signals and lighting to improve safety features

Impacts:

10th Street North between 4th Avenue to 12th Avenue North is closed to thru traffic. Traffic is detoured to University Drive where it is one lane in each direction.

Sidewalks on the east and west side of the project will remain open until the roadway reconstruction is complete.


Timeline:

Active construction began in May 2018. Project work is slated to be complete late September.


Funding:

NDDOT is funding the project with a majority of federal and state funds. The City of Fargo has participating items for infrastructure improvements.

Project cost is $7.1 Million:

  • Federal: $4.1 Million
  • State: $0.5 Million
  • City: $2.5 Million (city infrastructure improvements to sanitary sewer and water main work)
